Project Description
- Project scope includes installing second conductor on double-circuit 230 kV line from Graceton to Raphael Rd
- No substation equipment will be replaced
- Overall project length is approximately 20 miles
- PSC approval received March 4, 2020
- This project is subject to PSC approval and design changes
Resources
Timeline
April 2018
Begin Design and Engineering
February 2020
Complete Design and Engineering
February 2020
Open House Meetings
March 4th, 2020
PSC Administrative Hearing Complete
March 2020
Construction Start
June 2021
Project Service Date

Photo Simulation
View from Brickhouse Lane looking north. This project is subject to PSC approval and design changes.

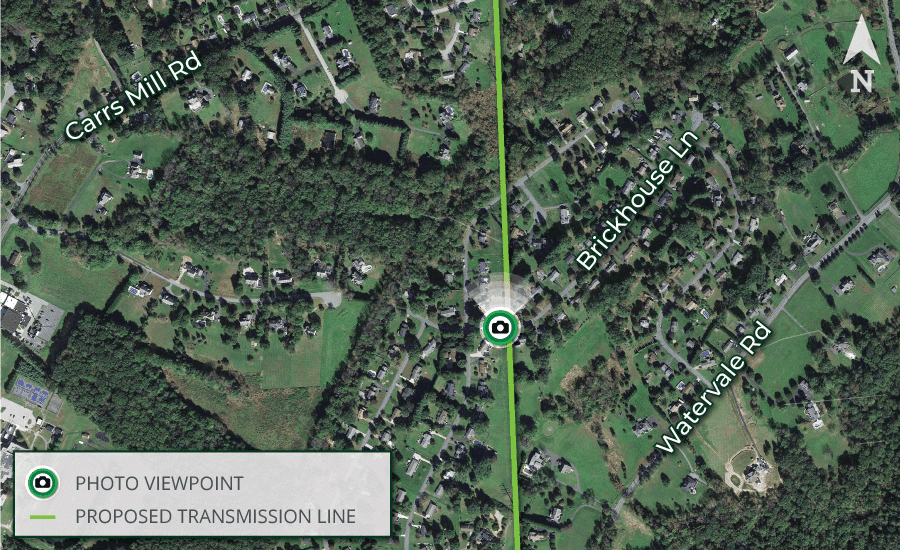

Viewpoint Location Map

Construction Sequence
Construction sequence graphics are intended to provide an overview of the typical construction sequence for a project. These graphics are used to give stakeholders a general idea of what to expect regarding this project’s construction process and effort. This project is subject to PSC approval and design changes.
